A digital operations room should not be imagined as a large screen showing every plant metric. Its real purpose is to preserve the continuity of decisions across shifts, functions, and levels of management.
It should help the next person inherit the situation, not merely inherit a list of statuses.
That difference is easy to miss. Manufacturing organisations have invested heavily in control rooms, dashboards, alarm systems, production boards, shift reports, and management reviews. Yet people still begin a difficult shift by asking:
“What happened before I came in?”
“What did the previous team already try?”
“Which information should I trust?”
“What decision is waiting for me?”
The digital operations room should be designed to answer those questions while there is still time to act.
FAQ targets
By the end of this chapter, you must have answers for these questions:
- What does the digital operations room mean for manufacturing leaders?
- How can organisations apply this idea in manufacturing?
- What role do people and governance play?
- How can success be measured?
The situation people actually experience
At shift change in an integrated steel plant, one person knows why a coil was held, another knows the customer consequence, and a third knows which crane is available. The board may show the order as delayed. The production system may show the batch as complete. Quality may still be waiting for evidence. Internal logistics may know that the bundle is in an inaccessible yard location.

The facts are present, but the story is fragmented.
If the handover records only “order delayed,” the next shift must recreate the reasoning under pressure. They may call the outgoing planner, search through messages, ask the quality laboratory, check a spreadsheet, and walk to the yard. The organisation spends the first hour of the shift recovering context that should have travelled with the decision.
This is not simply an inconvenience. It changes the quality of the next choice. While people reconstruct the situation, a truck slot may disappear, a customer may receive an outdated promise, or a production sequence may move beyond the point where recovery is practical.
The central argument
The digital operations room should be a continuity layer for the enterprise’s most important operating decisions.
It should connect four things:
1. What changed: the signal, event, exception, or deviation.
2. Why it matters: the affected customer, production plan, safety condition, quality status, or project commitment.
3. What choices remain: the feasible actions, their consequences, and the time available.
4. Who must act next: the owner, authority, deadline, and escalation path.
The room becomes useful when it allows people to continue a decision rather than restart it.

It should not attempt to remove every conversation. Some decisions need discussion because the consequences are real and competing. The purpose is to make that discussion informed, focused, and continuous instead of repetitive and dependent on whoever happens to remember the previous shift.
Why status is not enough
Manufacturing systems are good at representing states. An order is open, released, in production, complete, blocked, packed, dispatched, or delivered. A machine is running, stopped, available, under maintenance, or in an alarm state.
But a state does not explain its meaning in the current situation.
“Complete” may mean that the required tonnes have been produced. It may not mean that the quality certificate is available, the material is packed, the full customer bundle is ready, or the truck can be loaded. “Available capacity” may exclude the changeover time, skilled labour, furnace condition, or downstream constraint that an experienced scheduler knows immediately.
The operations room must therefore distinguish between:
- a recorded status;
- an interpreted condition;
- a decision requiring attention;
- and an action that has been authorised.
When these are collapsed into one coloured indicator, people are forced to guess what the colour means and whether somebody has already acted.
The handover as a design problem
Shift handover is often treated as an administrative ritual. In reality, it is one of the most important decision boundaries in the plant.
The outgoing team has memory, context, and an understanding of what is fragile. The incoming team has authority for the next period but may not yet know which assumptions are safe. A good handover transfers more than tasks. It transfers the logic of the situation.
A useful digital handover should answer:
- What changed during the shift?
- Which decisions were made?
- Which decisions remain open?
- What evidence supports the current interpretation?
- Which workarounds were used?
- What must the incoming team check first?
- What should not be done without approval?
- Which customer or production commitments are exposed?
- When is the next decision window?
The aim is not to create a longer report. It is to preserve the minimum context needed to act safely and intelligently.
A human example: the order that looked ready
Imagine a customer order for a set of steel products that must be delivered together. During the afternoon shift, production completes most of the material. The ERP status changes to complete for the individual lines. A quality sample from one line is sent for additional review because the surface condition is uncertain.
The planner makes a note that the order should not be promised as ready until quality confirms release. The logistics coordinator discovers that the bundle cannot be moved until a crane becomes available after midnight. Customer service tells the customer that an update will be provided in the morning.
At the night-shift handover, only the production completion status is visible on the main board. The planner’s note is in a shared spreadsheet. The quality status is in a laboratory queue. The crane restriction is known by the logistics team but not displayed against the order.
The incoming shift sees an order that appears nearly ready. If they arrange a truck for the early slot, the vehicle may wait. If they communicate that the order is ready, the customer may plan around a promise the plant cannot fulfil. If they hold the order without explaining why, they may create a new escalation.
The problem is not that one person failed to work hard. The problem is that the decision context did not travel as one object.
What a digital operations room should show
The live situation
Show the affected order, asset, line, project, or customer commitment in a way that brings related evidence together. Avoid forcing the user to navigate across five systems before understanding the case.
The change history
Show what changed, when it changed, and which source reported it. A current status without a timeline can hide how quickly the situation is deteriorating.
The decision ledger
Record the decision owner, options considered, evidence used, unresolved questions, action taken, and next review time. This is the thread that connects shifts.
The remaining choices
Display feasible alternatives and what each one protects or consumes. A list of problems without choices creates anxiety but not action.
The authority boundary
Make clear who may recommend, approve, execute, or stop. The room should not send a request to a group when one accountable role is needed.
The human context
Include relevant operator observations, planner notes, quality cautions, and logistics constraints. These should be structured enough to be found and reviewed, but not so rigid that people stop recording what they know.
From prediction to action
Prediction can identify an emerging delay, abnormal process behaviour, quality concern, capacity conflict, or shift-risk pattern. The operations room becomes valuable when it translates the prediction into a continuity question:
“Who needs to know, what does this affect, what has already been attempted, and what choice is still available?”
For example, an equipment model may predict that a line is likely to lose availability in the next six hours. A predictive screen might show a probability curve. A decision-centred operations room would connect that prediction to:
- the orders currently dependent on the line;
- the next customer promises;
- alternative lines or sequences;
- maintenance availability;
- quality and safety procedures;
- the next shift’s staffing;
- and the authority required to change the plan.
The prediction becomes operational only when it changes the conversation before the decision window closes.
When the operations room fails
Failure should be diagnosed at the level of continuity, not only interface design.
Information overload
The room displays every metric but does not help people identify what deserves attention now. More data increases the search burden.
Context loss
The current status is visible, but the reason for the status, previous actions, and unresolved questions are missing.
Conflicting truths
Production says the order is complete, quality says it is not released, and logistics says it is not movable. The room exposes disagreement without helping the team resolve the definition.
Stale handover
The decision ledger is updated after the meeting rather than during the work. By the time the next shift reads it, it is already out of date.
Unclear ownership
The room shows an exception but not the person who can decide. Everyone sees the problem; nobody knows who should act.
False confidence
The dashboard displays green because a transaction completed, even though the customer-level outcome remains uncertain.
Alert fatigue
The system raises too many notifications, so operators learn to treat the important ones like the rest.
These failures are signals that the room has been designed as a display layer rather than as a decision continuity layer.

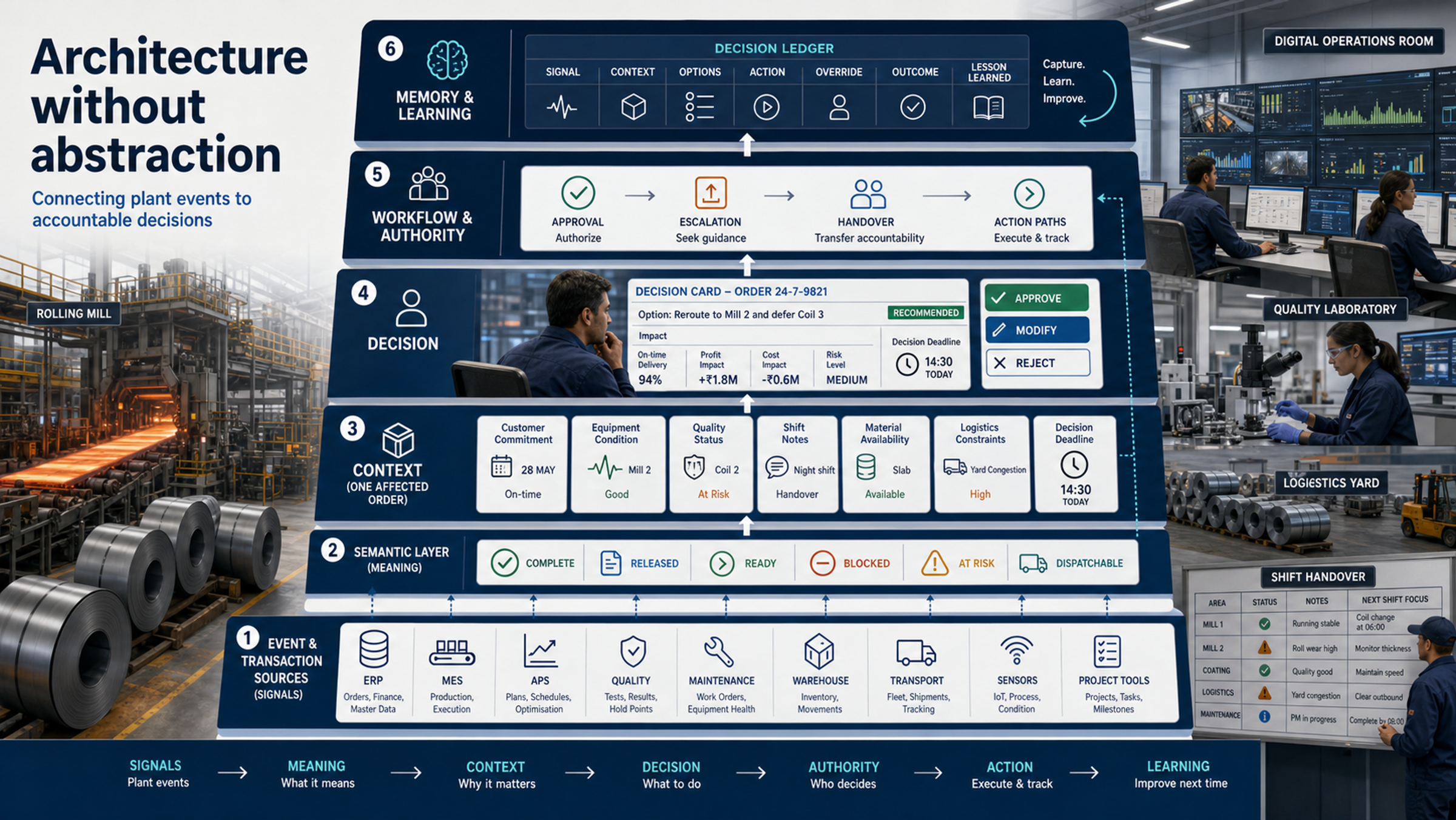

Architecture without abstraction
The architecture should follow the decisions that cross shifts and functions.

Event and transaction layer
ERP, MES, APS, quality, maintenance, warehouse, yard, transport, sensor, and project systems provide the underlying records and signals.
Semantic layer
This layer defines terms such as complete, ready, released, blocked, at risk, and dispatchable. A shared vocabulary is essential when several functions use the same word differently.
Context layer
The context layer connects events to the affected order, asset, customer, product, line, and decision window. It also includes evidence age, source reliability, and relevant human notes.
Decision layer
Rules, models, and agent assistance identify what deserves attention, compare alternatives, and prepare a recommended next step. The system should be able to say when there is not enough evidence.
Workflow and authority layer
Route decisions to the right role. Record approvals, rejections, escalations, and stop actions. Avoid sending every issue to a general operations queue.
Memory and learning layer
Preserve handover context, overrides, outcomes, and explanations. This allows the room to improve rather than remain a more attractive version of the same daily meeting.
A practical 90-day sequence
Days 1–30: Observe the handover
Choose one shift boundary and one recurring decision that often loses context. Sit through the handover. Compare what is said aloud, what is written down, what exists in systems, and what is carried only in memory.
Create a timeline for several real cases. Mark where the signal appeared, where the interpretation changed, where a decision was made, and where the next shift had to reconstruct the story.
Days 31–60: Build the minimum continuity record
Create a simple decision ledger with the situation, current risk, evidence, options, owner, next decision time, and prohibited shortcuts. Keep it small. If people cannot update it during a busy shift, it will not remain useful.
Connect only the minimum system information required to reduce reconstruction. Do not begin by displaying every plant metric.
Days 61–90: Run the room in shadow mode
Let the digital operations room prepare the handover and identify unresolved decisions without changing production or dispatch actions. Compare its view with the outgoing and incoming teams.
Measure time to understand, repeated calls, reopened questions, missed ownership, and decisions that became easier because context was available earlier.
After 90 days: Improve the operating rhythm
Decide which handover decisions should receive recommendations, which require a human conversation, and which can be supported by bounded automation. Review exceptions and near misses as carefully as successful outcomes.
Questions for leaders
- Which decisions lose the most context during shift change?
- What does the incoming team routinely have to reconstruct?
- Which status terms mean different things to different functions?
- What should the next shift know before it opens another system?
- Which human observations are important but currently disappear?
- Where does the room show a problem without showing an owner?
- Which alert would be more useful if it arrived with a choice?
- How will we know that the handover has improved?
Conclusion: preserve the thread of the decision
The best operations room does not make the plant noisier. It makes important uncertainty harder to lose.
It does not replace the operator’s judgement, the planner’s experience, the quality team’s caution, or the shift incharge’s authority. It gives those forms of knowledge a place to meet, persist, and travel across the boundaries of the working day.
The difference between a status board and a digital operations room is the difference between seeing that something is wrong and understanding what must happen next.
Begin with one handover, one recurring decision, and one honest record of what the next shift needed but did not receive. Then build from evidence. A useful operations room is not defined by how much information it displays. It is defined by how much unnecessary reconstruction it removes while keeping accountability visible.
Disclaimer
Industry situations in this chapter are composite illustrations unless explicitly attributed to a public source. They are not claims about any particular company, plant, vendor, or incident. Implementations must be validated against local safety, quality, cybersecurity, regulatory, contractual, labour, and data-governance requirements.
